Before the first brick is laid, the numbers must add up. Here is how estimation works  and why it matters to your business.

Every construction project, whether it is a two-room house in a small town or a 10-storey office tower in Patna starts with one question: How much will this cost?

The answer comes from estimation  the process of calculating the quantity of materials, labour, and machinery needed for a project, and then putting a price tag on all of it. If you are a contractor bidding on a project, or a supplier trying to plan your inventory, understanding estimation is not optional. It is the foundation of your business.

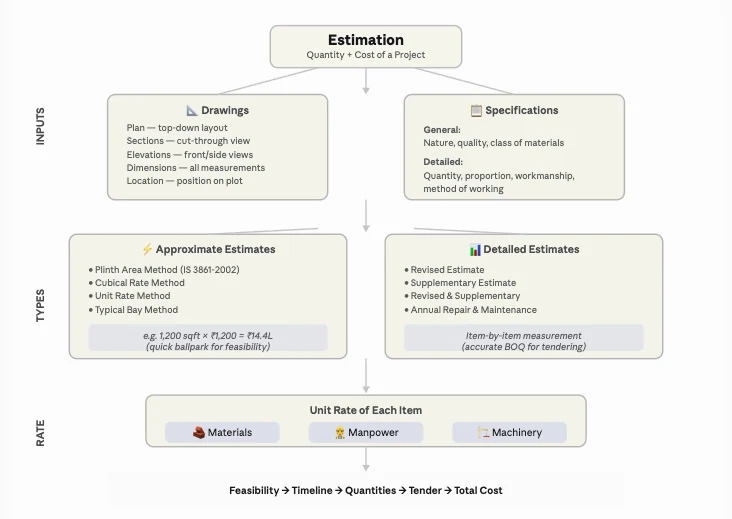

What Exactly Is Estimation?

Estimation is the technique of calculating two things:

  1. 1.  How much material you will need (cement, steel, bricks, sand, etc.)

  2. 2.  How much it will all cost (3M - materials + manpower+ machinery)

Why Should You Care About Estimation?

Whether you are a contractor or a supplier, estimation touches every part of your work. Here is what a good estimate helps you do:

Know if the project is even possible. Before anyone starts digging, the estimate tells the owner whether they can afford the building they want. Many projects are redesigned or shelved at this stage itself.

Plan your timeline. When you know the quantities, you can figure out how long each activity will take.

Order the right quantities. Too little material means work stops. Too much means money wasted sitting in your godown. A good estimate gets you close to the right number.

Bid on tenders with confidence. If you are a contractor responding to a government or private tender, your estimate is your bid. Get it wrong, and you either lose the contract or lose money executing it.

Control the total cost. The estimate is your budget. It is the number everyone — the owner, the engineer, the contractor — keeps coming back to throughout the project.

Before You Estimate: What You Need on Your Table

You cannot estimate without drawings and specifications.

Drawings

These are the architect's and engineer's blueprints. A set of drawings typically includes:

  • •  Plan — the top-down view showing room layout, walls, and dimensions

  • •  Sections — a cut-through view showing floor heights, slab thickness, foundation depth

  • •  Elevations — the front, back, and side views of the building

  • •  Location — where the building sits on the plot

  • •  Dimensions — the actual measurements (length, width, height) of every element

Without clear drawings, estimation is guesswork.

Specifications

Specifications tell you the quality and method of work. They come in two types:

General specifications describe the nature, quality, and class of materials. For example: "Use OPC 43-grade cement" or "Bricks shall be first-class burnt clay bricks."

Detailed specifications go deeper. They cover the exact quantity, proportion, method of working, and expected level of workmanship for each item. For example: "Plaster shall be 12mm thick, in 1:6 cement-sand mortar, finished smooth."

Together, drawings and specifications give you everything you need to start calculating.

The Two Main Types of Estimates

Not every project needs the same level of detail in its estimate. Broadly, there are two categories:

  1. 1. Approximate Estimates

These are quick, rough calculations done early in a project — usually when the owner just wants a ballpark figure. There are several methods:

Plinth Area Method — This is the most common one. You calculate the plinth area (the covered area of the building at ground level) and multiply it by a rate per square foot.

Here is a simple example:

Project: A residential building with a plinth area of 1,200 sq ft Rate: ₹1,200 per sq ft (a typical range is ₹1,000–1,500 per sq ft depending on location and finish) Estimated cost = 1,200 × ₹1,200 = ₹14,40,000

This method is described in IS 3861-2002, the Indian Standard for this kind of calculation.

Cubical Rate Method — Here, you calculate the total volume of the building (length × width × height) and multiply by a rate per cubic foot. Useful for buildings with varying floor heights.

Unit Rate Method — Commonly used for projects like roads, canals, or pipelines where you estimate cost per kilometre or per unit length.

Typical Bay Method — Used in repetitive structures like warehouses or industrial sheds, where you estimate one "bay" (one repeating section) and multiply by the number of bays.

Approximate estimates are fast but not precise. They are good for feasibility checks and initial budgeting.

  1. 2. Detailed Estimates

When the project moves forward and you need accurate numbers for tendering and execution, you prepare a detailed estimate. This involves measuring every single item of work from the drawings and calculating exact quantities.

A detailed estimate has its own sub-types:

Revised Estimate — Prepared when the original estimate needs to be updated due to design changes or rate revisions (usually when the change exceeds 5% of the original).

Supplementary Estimate — Prepared when new items of work are added that were not part of the original scope.

Revised and Supplementary — A combination of both — when there are changes in existing items and new items added together.

Annual Repair and Maintenance Estimate — A yearly estimate for upkeep and repairs of existing buildings or infrastructure.

How to Calculate the Unit Rate of an Item

Every item of work in an estimate — say, "brick masonry in cement mortar" — needs a rate. That rate is built from three components:

Materials — Cost of bricks, cement, sand, water, etc., for that specific item, including wastage and transport. You call ConstroMat for cost of Materials.

Manpower — Wages of masons, helpers, and supervisors needed to do the work.

Machinery — Cost of equipment like mixers, vibrators, or cranes if the item requires them.

Here is how it comes together:

When you multiply this rate by the total quantity of brick masonry in the building, you get the cost for that item. Add up all items, and you have your detailed estimate.

A Quick Note on Carpet Area

If you deal with residential or commercial projects, you will often hear the term carpet area. This is the usable floor space inside a room — the area where you can actually lay a carpet. It does not include walls, balconies, staircases, lift shafts, bathrooms common areas, or AC ducts.

As a rough guide:

  • •  Office buildings: Carpet area is usually 60–75% of the total built-up area

  • •  Residential buildings: Carpet area is usually 50–65% of the total built-up area

Knowing this helps you give realistic area figures to clients and avoid confusion during estimation.

Getting It Right: Practical Tips

After 20+ years in the field, here are a few things I have learned about estimation:

Always double-check your measurements. A small error in length or width gets multiplied across hundreds of items. A 2% mistake in measurement can become a 5–10% mistake in cost.

Use current market rates. Material prices change every quarter. An estimate based on last year's rates is already outdated. Platforms like ConstroMat can help you stay updated on real-time material prices.

Do not forget overheads. Water, electricity, site office, safety equipment, insurance — these are easy to miss but they add up to 8–12% of the project cost.

Keep a contingency. Even the best estimate cannot predict everything. A 5–10% contingency for unforeseen work is standard practice.

Wrapping Up

Estimation is not just paperwork. It is the difference between a profitable project and a loss-making one. Whether you are preparing a rough plinth area estimate for a client meeting or a detailed bill of quantities for a government tender, getting the numbers right is what separates the professionals from the rest.

If you are looking for reliable material rates and want to simplify your procurement, visit ConstroMat — we help contractors and suppliers across eastern India get the right materials at the right price.

Need help with material rates? Reach out to us at ConstroMat — we are here to help you build better.
